Skip to main contentSkip to footer

Lake Chillisquaque
Spillway Upgrade

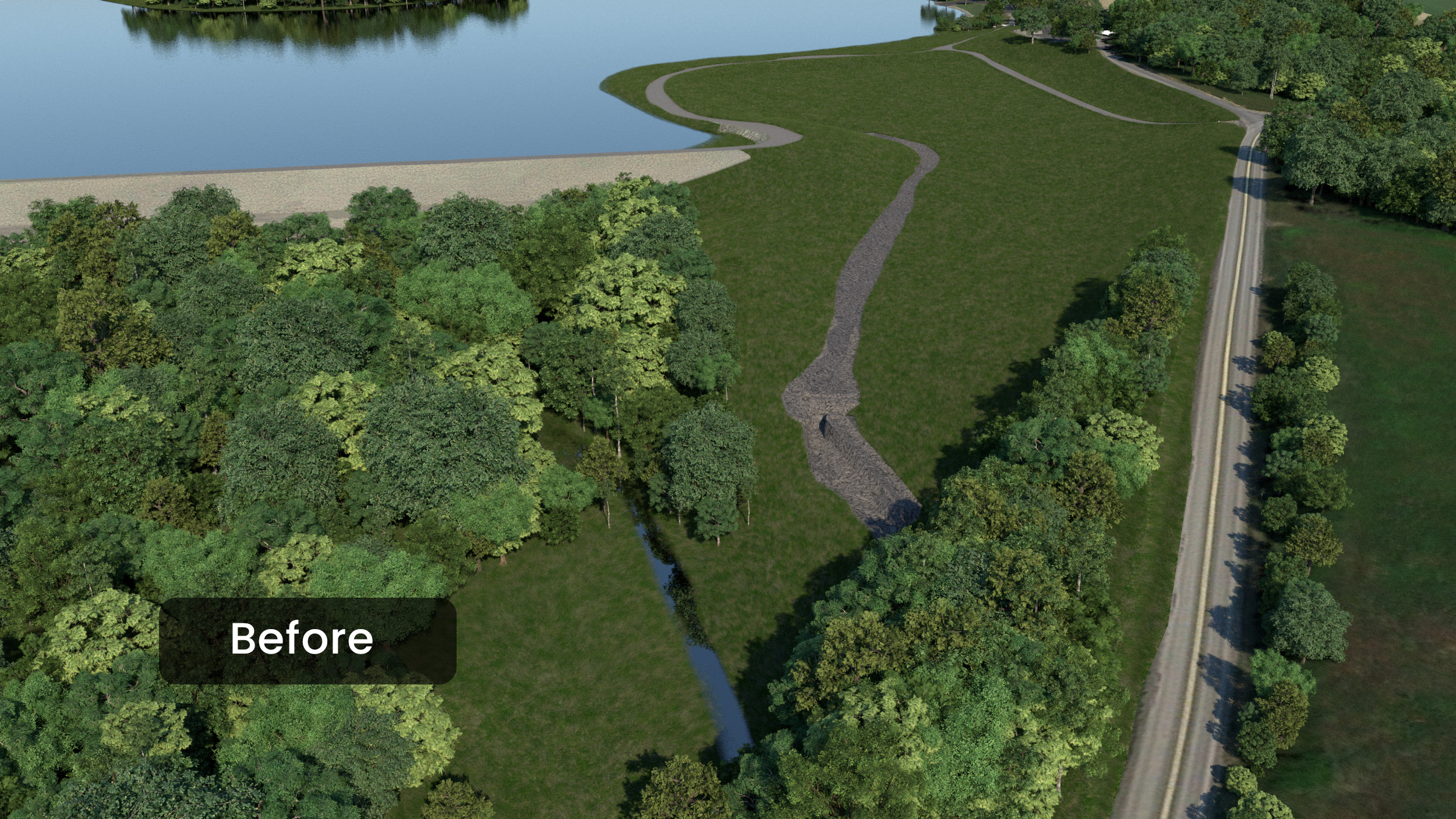

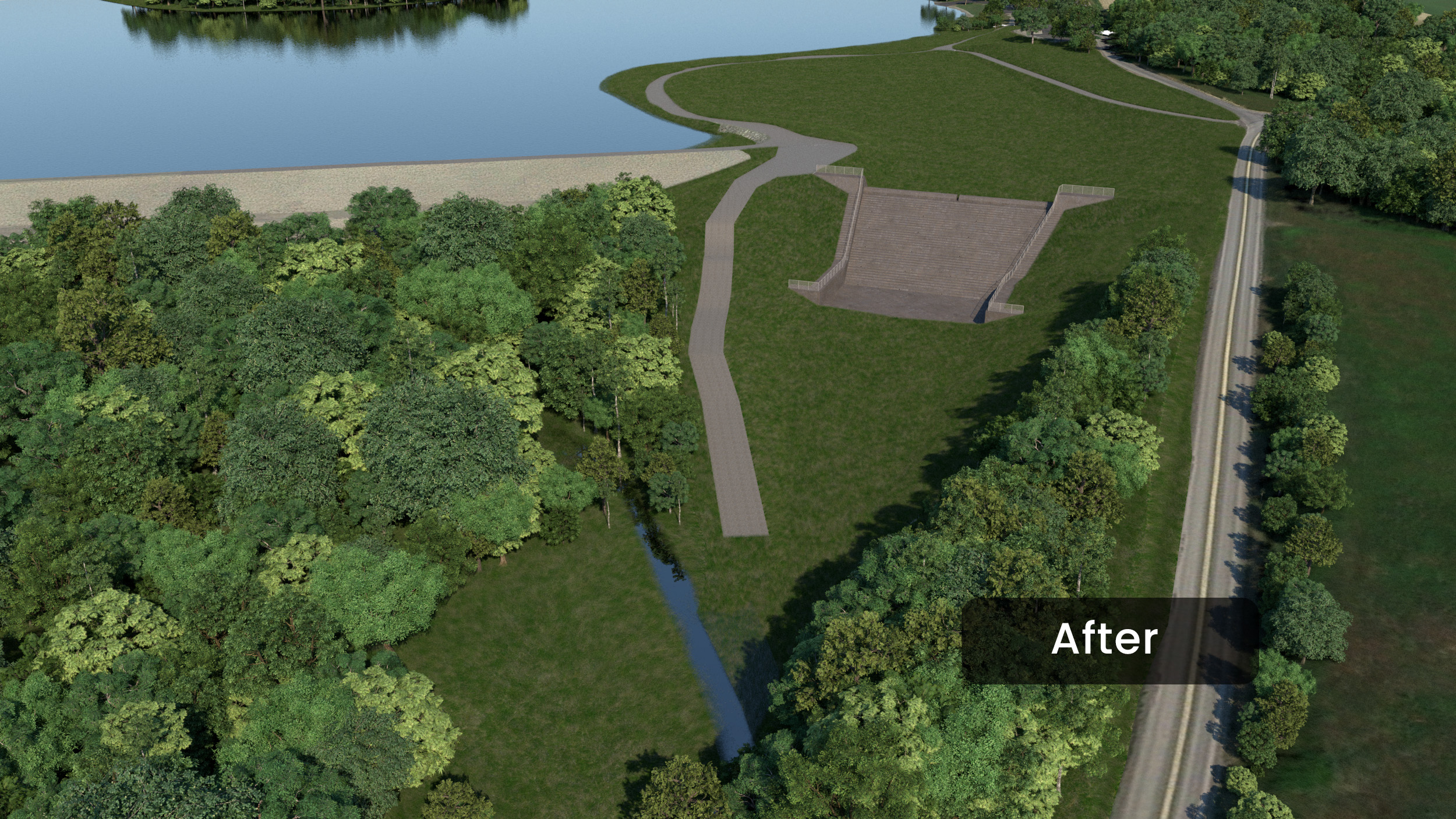

Before Upgrade After Upgrade (Rendering)
Before & After (Slide to View)

The Lake Chillisquaque spillway directs water away from the lake in the event of significant rainfall. The manmade lake is located within the Montour Preserve.

The auxiliary spillway will be upgraded to slow down the flow of water when the spillway is activated and reduce the risk of erosion by deepening the channel and constructing a protective, stepped concrete structure within it. The project follows Pennsylvania Division of Dam Safety guidelines, improves public safety, and ensures the long-term viability of the lake and preserve.

Quick Facts

Lake Chillisquaque was originally built as a water source for the Montour Steam Electric Station constructed in the early 1970s.

The lake serves as a backup water supply for the power plant, owned by Talen Energy.

Talen Energy owns the lake and makes it available for public use including boating and fishing.

The Montour Area Recreation Commission (MARC) manages the Montour Preserve, in partnership with Talen Energy.

Construction is expected to commence in Spring 2026 and last 12 to 18 months.

During certain phases of the project, access to certain amenities at the Montour Preserve may be temporarily unavailable. Check for the latest updates here.

FAQs

Spillways direct water away from bodies of water like lakes and reservoirs in the event of significant rainfall while maintaining the integrity of the reservoir.

The project will expand and deepen the spillway. It will also install a concrete drop structure within it. The project includes 3 key phases: excavation, construction of the concrete drop structure, and site remediation.

The updated spillway will slow the flow of water from the lake in the event of a significant rainfall event, which will improve its functionality and help minimize future erosion. The new structure will also extend the spillway’s longevity.

Talen, with oversight and approval from the PA Department of Environmental Protection (PADEP) and the Army Corps of Engineers, made repairs and improvements to the spillway after a significant rainfall event in 2018. In 2019, Talen, in conjunction with PADEP, began the modeling and analysis work needed to support this project. In 2022, Talen submitted a dam safety permit modification request to PADEP to rehabilitate and improve the spillway. Talen received permit approval from PADEP in December 2025 and immediately began an RFP process for the project.

Construction is expected to start in the spring of 2026 and last approximately 12-18 months.

The project will consist of three major phases:

  1. Excavation – The spillway will be expanded and deepened to accommodate a roller compacted concrete (RCC) drop structure and stilling basin. During the excavation phase of the project, it will be necessary to use controlled, low-level blasts to loosen and remove select sections of rock below the surface of the existing spillway channel. This is a common construction practice, and experienced contractors will follow a comprehensive plan to safely complete this work. The activity is expected to occur once a week for a handful of weeks in early to late summer, with the blast itself taking only a few minutes. Engineers have compared the magnitude of the blasting, which is only expected to be felt in close proximity to the site, to a large truck driving down a two-lane road.

    As a safety precaution, access to sections of the Montour Preserve will be limited for a short period of time just prior to and following each event.  Traffic on adjacent roadways will also be halted while blasts take place.

    Notifications will be sent to neighbors, posted on the project website, and shared on social media well in advance of any scheduled blasting, and every effort will be made to minimize the impact to visitors and neighbors.

  1. Drop Structure Construction – Following excavation, a roller compacted concrete (RCC) drop structure will be constructed on site, and a stilling basin will be installed within the existing auxiliary spillway channel to safely convey spillway discharges.
  2. Site Restoration – Final grading will be completed during this phase and disturbed areas will be restored with grass, which is the preferred cover to support inspections and observe deficiencies. Grass cover will support permanent stabilization of the site.

Minimal disruptions could temporarily impact amenities at the Montour Preserve during certain phases of the project. Those include access to the pavilions, a portion of the Chilisuagi trail, and the boat launch. We are working closely with MARC and other stakeholders to communicate with the community in advance of these temporary disruptions. We will also post information on our website. Please continue to check this website and/or sign up for project updates.

Updates about the project will be posted on this website. You can also sign up to receive updates using the form on our site. The Montour Area Recreation Commission and other local stakeholders will also share key updates on their social channels.

Project Updates

Amenity Access

During certain phases of the project, access to certain amenities at the Preserve may be temporarily unavailable. Updates will be posted here.

  • A portion of the Chillisuagi Trail, between the dam and the Heron Cove Boat Launch Parking Lot, will be closed to all use for most of the construction period.
  • Lake Chillisquaque will remain open to fishing and boating during construction, though lake levels will be lowered and access to the shoreline along the spillway will be restricted.

Timeline

The following timeline details the recent history of the dam and the expected timeline for the upgrade project.

Join our mailing list for the latest project updates:

Contact

Do you have any questions or concerns related to the spillway upgrade project? Please fill out the contact form, and we will be in touch with you as soon as possible.
